Executive Summary
Twenty-two artificial date palms at 6.5–9 m, set 4 m back from a resort pool edge, were fixed on cast-in stainless anchors rather than ballast collars: at a 45 m/s design gust the crown sail area of a 9 m specimen produces roughly 33 kN·m at the base, which no planter can resist. Three 40HQ loads, five night windows, sixteen weeks from RFQ to handover.

1. What Goes Wrong Without This
The project is a Gulf-coast resort refurbishment: an existing pool terrace rebuilt with 22 date palms between 6.5 m and 9 m, arranged in three groups around the deck, with the water edge four metres from the nearest trunk. The client is not named. The numbers are the project's own.
Pool terraces punish artificial palms in ways an entrance plaza never does, and the failures arrive in a fixed order.
Chlorine and splash first. Water at 1–3 ppm chlorine reaches the lower trunk and the base plate through splash and deck washing. Evaporation concentrates the salts at the trunk-foot junction, which is exactly where the fixing sits. Grade 304 stainless in that environment pits within one season; aluminium base plates corrode and bleed a white streak across pale paving that no amount of cleaning removes. A 316 fixing set costs 15–25% more and removes the failure entirely.
Wind second. The deck is open to the sea on one side. At a 45 m/s three-second gust, a 9 m palm with a 5.5 m² crown carries about 7.4 kN of drag, and the lever arm to the base makes that roughly 33 kN·m. A ballast collar heavy enough to resist that overturning moment would need 6–8 tonnes of concrete inside a planter, which the structural slab would not accept. The right answer was cast-in anchors, and the wrong answer — a lighter collar rated by eye — would have been discovered in the first shamal.
Reflected exposure third. Pool water and pale travertine bounce light back into the canopy from below, so the underside of the fronds takes a dose that an inland installation never sees. Non-stabilised fronds lose their green on the shaded side first, which is the side facing the sun loungers.
Sequencing fourth — and the most expensive. On this deck the waterproofing membrane sits under the screed and over the structural slab. Drilling an anchor hole after the travertine is laid means breaking the membrane, re-tanking a 300 mm collar around each hole, and waiting two to three days for cure before the paving goes back. Fourteen of those, and the pool opening slips a week.
The cost of getting the order wrong is not the tree. It is the paving, the membrane, the plant-room leak investigation, and the crane that has to come back.
There is a slower cost too, and it lands on the operator rather than the contractor. Splash-zone hardware needs a rinse every two to four weeks and a torque check at twelve months; standard outdoor hardware on the same deck needs neither, because it fails outright instead of degrading gradually. A specification that ignores the splash distance does not remove the maintenance, it converts a scheduled rinse into an unplanned base replacement in year two, at resort-occupancy rates.
2. The Decision Framework
Eight questions decide the specification before a supplier is chosen. They are written to be answered from drawings and from the site, not from a catalogue.
1. What is the clear distance from the water edge? Under 2 m, the trunk foot takes direct splash and the hardware has to be 316 stainless with a sealed base collar. 2–5 m, splash is incidental and hot-dip galvanised steel with a C5-M coating system holds. Over 5 m, standard outdoor hardware is adequate. This single dimension sets the maintenance interval as well as the material.
2. What is the design gust, from which code? Get the number from the project's structural engineer against the local code — SBC 301 in Saudi Arabia, ASCE 7 elsewhere, EN 1991-1-4 in Europe — with the exposure category stated. A supplier claim of "wind resistant" is not a number and cannot be checked.
3. What is the sail area of the crown at the specified height? A 6.5 m palm with 24 fronds presents roughly 3.5 m²; a 9 m specimen with 30 fronds presents 5–5.5 m². Sail area, not height, drives the base.
4. Which fixing suits the deck build-up? Cast-in sockets set before the screed; chemical anchors drilled after the paving with the membrane protected; or a ballast collar where nothing may be drilled. The build-up drawing decides, not preference.
5. Does the slab accept the load? An anchored palm puts a local tension of 14–20 kN per bolt into the concrete. On a suspended slab that has to be checked; on grade, it is a footing question.

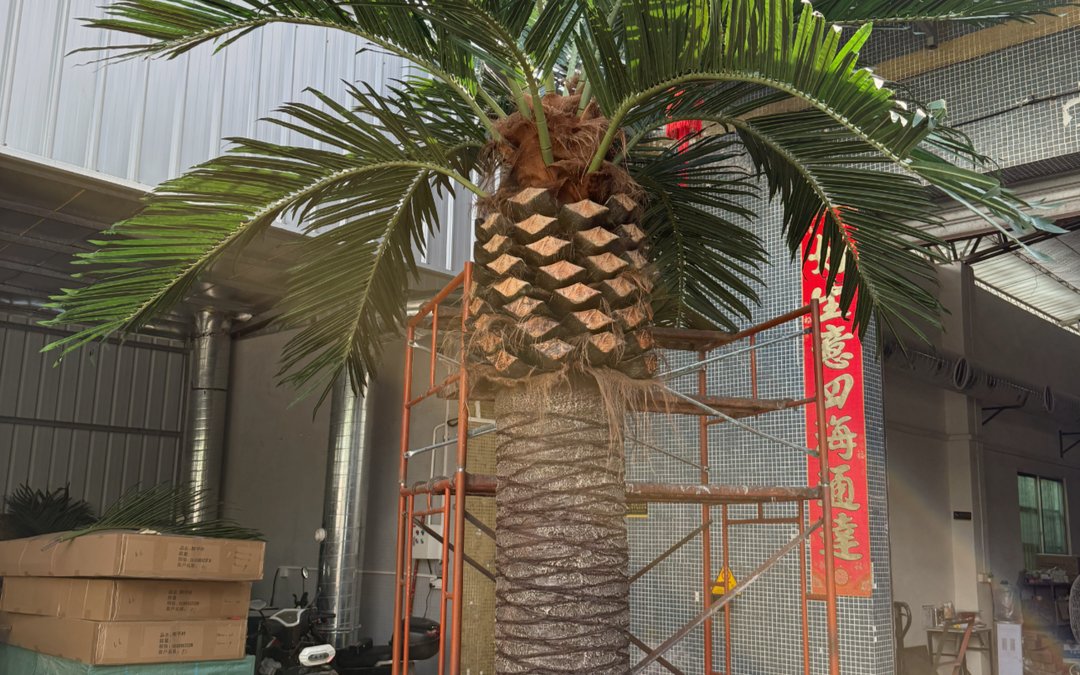

6. What is the core and shell? Above 5 m, a Ø60–76 mm hot-dip galvanised core inside a 3–5 mm fiberglass shell. A foam-core trunk at 9 m in a coastal wind is a replacement waiting to happen.
7. How many fronds, and at what density? 22–30 fronds for a 6–9 m crown, with deliberate variation in angle. Uniform spacing is the fastest way to make a palm read as a prop.
8. What arrives at handover? Anchor engineering calculations signed by an engineer, pull-test records for 5% of anchors at 1.5× design load, a cleaning procedure matched to the coating, and 3% spare fronds in the same batch.
9. Who cleans the fronds, and with what? A pool deck gets hosed, not dusted, and chlorinated water is not neutral to every coating. The cleaning method has to be agreed before the finish is chosen, because a matte finish that survives a dry cloth may not survive a pressure rinse at 80 bar.
10. What is the replacement plan at year three? Fronds are the consumable part. A crown that can be re-fronded on site, with the joint and the tool specified, avoids taking a palm out through a plant room door. If the crown is sealed at the factory, that decision belongs in the budget now rather than after the first storm.

A hospitality spec written for a city hotel transfers about half of these answers. Poolside work adds the splash dimension, the reflected exposure and the night-window installation, and those three are where the budget moves.
3. Numbers, Tiers and Timelines
| Stage | Typical Duration | Volume or Quantity | What It Decides | Owner |
|---|---|---|---|---|
| Anchor and wind design | 10–15 working days | 22 positions, 4 fixing types | Bolt grade, embedment, edge distance | Structural engineer |
| Finish and frond sample approval | 7–10 working days | 3 crown samples, 1 trunk finish | Colour, density, frond angle | Client and landscape architect |
| Production | 25–35 days | 22 palms, 3 setups by height | Delivery date, batch continuity | Factory |
| Packing and loading | 4–6 days | 3 × 40HQ at 1.1–1.4 CBM per palm | Knock-down split, crate count | Factory and forwarder |
| Sea freight | 18–26 days | 3 containers | Site readiness date | Forwarder |
| Installation | 5 nights × 5 hours | 4–5 palms per night, crew of 5 | Access route, crane position | Installer |
| Snag and handover | 3–5 days | 22 positions, 6-item checklist | Retention release | Main contractor |
Two numbers in that table are commonly misjudged. The first is production: 22 palms at three heights is three moulding and assembly setups, not one long run, and the setup changes are what stretch the schedule past a month. The second is installation density: a five-hour night window with a spider crane and a five-person crew lands four to five palms, not ten, once the deck protection and the base alignment are counted.
Container loading follows from the same data. At roughly eight 6 m palms per 40HQ with crowns packed separately, 22 palms plus planters and spare fronds fill three containers with two slots left for the planter crates.
The quantity take-off behind those numbers is worth writing down, because it is where quotes diverge. Twenty-two palms become 22 trunk assemblies, 22 crowns, 22 planters or base collars, 66 spare fronds at 3% rounded up per crown size, and a crate count that follows the crown diameter rather than the trunk length. On this project the crowns were the volume driver: three crown sizes, each needing its own crate footprint, and the palm count alone would have under-quoted the containers by one.
4. How to Apply It to a Live Project
The sequence below is the one this terrace followed, and each step has a single decision that cannot be deferred.
At RFQ. Issue the deck build-up, the water-edge distance and the design gust with the enquiry. A quotation without those three is a price for a different project. Expect the first response to be a range, not a number.
At sampling. Ask for a crown sample at the specified frond count, not a photograph. Check frond angle variation and the trunk finish at arm's length, then approve against the lighting on site rather than a showroom lamp.
At drawing stage. The base detail, the anchor template and the sightline rotation belong on the same sheet. On this project the palms were set so the fuller face of each crown turned toward the arrival walk, which required the bolt circle to be rotated before the sockets were cast.
At production. Freeze the frond count and the finish, then ask for the batch list by height. If production spans more than one masterbatch lot, get the colour readings per lot before loading, not after.
At shipping. Crowns travel detached and are re-attached on site; confirm the joint type and the tool required. A crown that needs a factory jig to seat cannot be installed on a pool deck at two in the morning.
At installation. Protect the paving before the first palm lands, set anchors in the sequence that keeps pedestrian routes open, and record torque values per position. The last palm on this deck went in on the fifth night with the pool already filling.
At handover. Walk the deck at the hour the guests will use it, not at midday. Six items belong on the checklist: verticality against a plumb line, torque value per base, frond count per crown against the approved sample, base collar seal, paving reinstatement around each fixing, and a photograph of every position with its tag number. That last item is what settles a warranty argument two years later, when nobody remembers which palm stood where.

5. Commercial Contractor FAQs
Q: How many 6 m date palms fit in a 40HQ container?
About eight, with the crowns packed separately from the trunk assemblies. A 22-palm order at mixed heights therefore needs three containers, and the planter crates take the remaining slots. Asking for a per-container count early is what keeps the freight estimate from doubling at booking.
Q: Can a date palm stand on a pool deck in a planter without drilling?
Only up to a point. A weighted collar is workable at 4–5 m in a sheltered position, but once the design gust and the crown sail area are applied, the ballast required climbs into tonnes and the slab usually rejects it. Above roughly 6 m on an open deck, cast-in or chemical anchors are the realistic route.
Q: Which stainless grade is needed four metres from a chlorinated pool?
316 with A4-70 bolts, sealed at the base. Grade 304 will pit at the splash line within a season, and the corrosion product stains pale paving permanently. The cost difference on a 22-palm project is small against re-paving a terrace.
Q: How long does installation take, and can it be done in daylight?
Five night windows of about five hours each on this deck, at four to five palms per night with a crew of five. Daytime work is possible only if the terrace is closed; on an operating resort the night window is what protects both the guests and the paving.
Project Engineering Support & CAD Requests
We package the anchor design, the base template and the crown sightline on one drawing set, and we release it before the sockets are cast so the sequence cannot invert. For pool terraces we also issue the pull-test schedule and a cleaning procedure matched to the coating system, plus spare fronds from the same production lot. Send the deck build-up and the design gust through WhatsApp and the fixing type can be settled in a single exchange.
