Executive Summary

A factory visit answers one question — does the building exist and does it make the product. It does not answer the question that decides whether the second container matches the first, and that question is commercial. The instrument that controls it is the payment ladder: a deposit tied to a signed first-article sample, an intermediate release against a pre-shipment inspection with a defined AQL, and a retention held until the container lands. A supplier who will not accept a milestone-linked deposit is telling the buyer something a photographed workshop cannot.

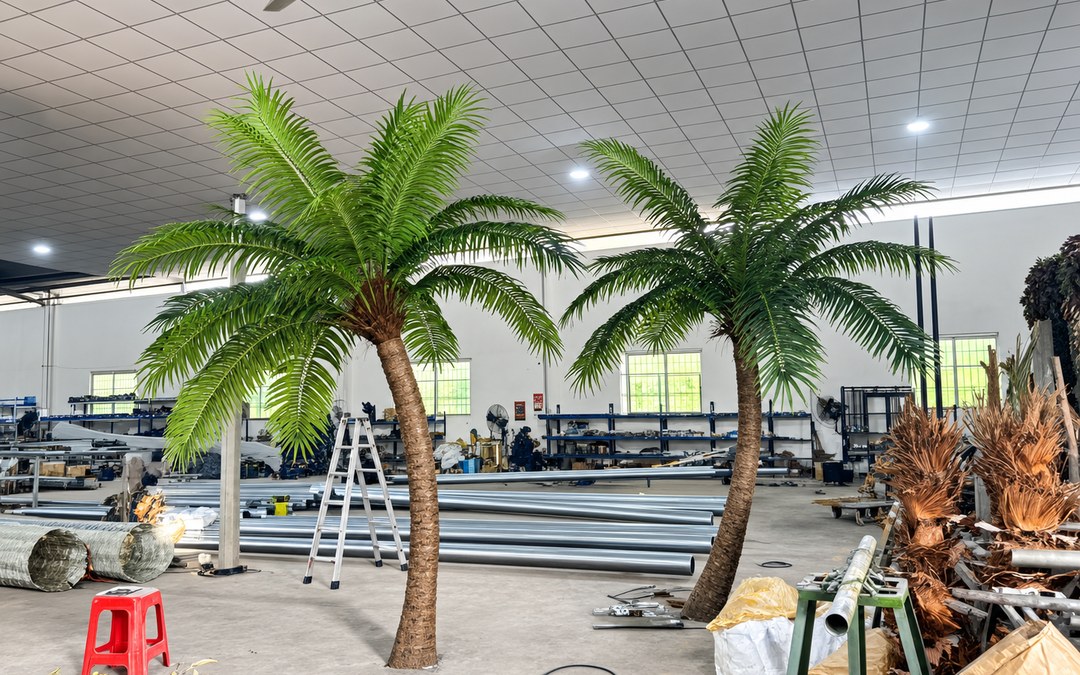

Two assembled date palms inside a factory workshop with galvanized tube stock on the floor Two assembled date palms inside the production hall, with galvanized steel tube stock, racks and spare frond clusters around them — the floor a buyer should actually see on an audit.

1. Failure Modes & Commercial Pitfalls

The audit that photographs everything and verifies nothing. A buyer travels to the factory, sees a workshop, sees trees, takes photographs, and returns satisfied. Three months later the second order arrives with a different foliage colour, a lighter core, and a weld that looks unfinished. Nothing about the first visit was wrong — it simply tested the wrong thing. A factory audit is a point-in-time check on a continuous process, and the gap between the two is closed by contract terms, not by more photographs. The same gap applies whether the order is a single specimen for a commercial atrium or a mixed container drawn from the whole tree range.

Why the second container drifts. Four mechanisms produce the drift, and each needs its own clause.

  • Sample decay. The approved sample sits in an office; production runs from a photo of it. Colour and frond density drift first, because those are the parameters a worker adjusts by eye.
  • Sub-tier substitution. The core tube supplier changes, or a batch of galvanized pipe arrives from a different mill. Nobody in the sales conversation knows, because the change is two tiers down.
  • Batch mixing after a rush. A peak season splits one order across two production runs; the two runs differ in dye lot.
  • Account and entity drift. The quotation comes from one company, the proforma invoice from a second, and the receiving bank account belongs to a third. This is the pattern that most often signals a trading intermediary behind a "factory".

The cost of not fixing this in the contract. Rework and replacement on a 40HQ of 6 m date palm is not a warranty conversation — the freight alone on a return leg can exceed the value of the disputed units, so the practical outcome is that the buyer absorbs the difference. That asymmetry is why the deposit and the retention carry more weight than the audit report.

The clause that fails on the first dispute. "Quality to be in accordance with the approved sample" — with no sample signed, dated and retained by both parties, this clause is unenforceable. It is the single most common omission, and it costs nothing to fix on the day the sample is made.

2. Material Science & Structural Engineering Standards

For an audit to be verifiable, the specification has to be written in numbers that a third party can check on the shop floor. Four parameters do most of the work.

  • Core tube. Q235 hot-dip galvanized steel at Ø48–76 mm depending on height, with a defined wall thickness. On the audit, this is a stock check: measure the tube on the rack, confirm the wall with a calliper, and confirm the galvanizing by the mill certificate rather than by the appearance of the surface. Galvanizing to ISO 1461 at 85 µm average is the baseline for exterior work.
  • Trunk construction. Centrifugal fibreglass over the core, 3–5 mm shell, with the joint between sections sleeved or flanged and not filled with foam. The audit question is specific: show me a sectioned joint, and show me the moment capacity. A joint that cannot be sectioned on request is a joint that has not been engineered.
  • Foliage. Injection-moulded PE at 1,800–3,200 leaves/m³ of crown volume, matched to a retained colour reference. Colour is where drift is easiest to introduce and hardest to prove after the fact — which is why a retained, dated sample matters more than any specification number.
  • Traceability. Every major component should carry a part number that links the drawing, the physical label, and the packing list. This is the mechanism that makes a claim checkable three years later: without it, a buyer holding a failed component cannot prove which production run it came from.

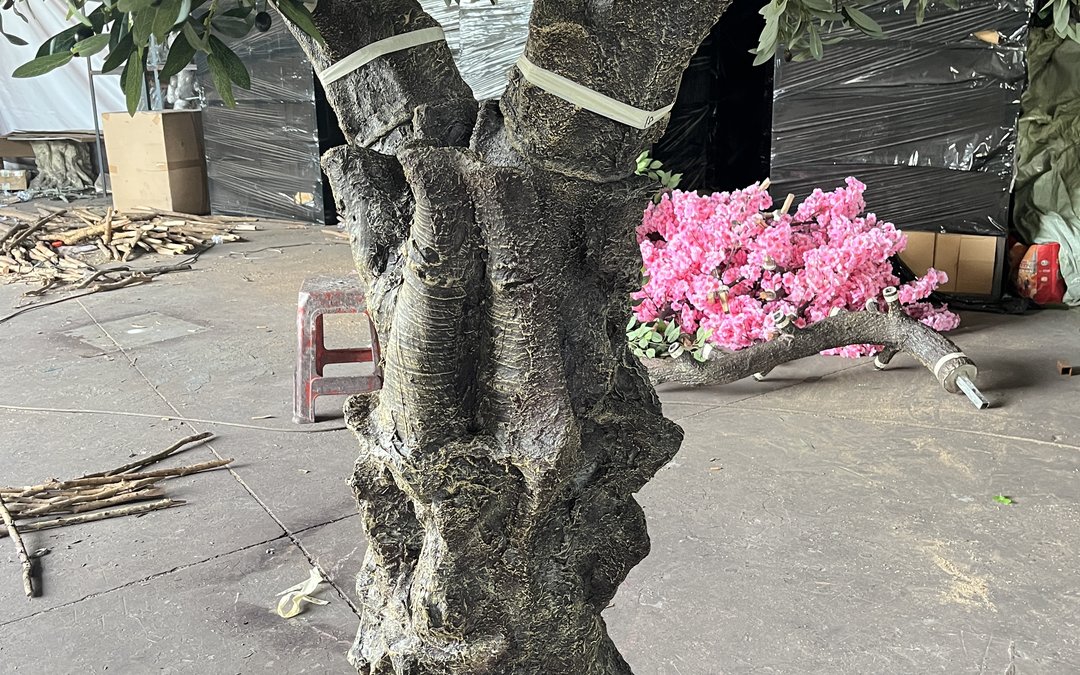

A fibreglass trunk in the workshop with the galvanized core exposed at a branch stub A fibreglass trunk in the workshop showing the wound bark texture, with the galvanized core insert visible at a cut branch stub — the production detail an audit should verify rather than photograph.

Turning the parameters into contract language. Each of the four should appear in the purchase order as a measurable value, not an adjective. "Dense UV-stabilised frond crown" is not checkable; "1,800–3,200 leaves/m³, colour matched to Sample No. 2026-XX retained by both parties" is. That is the level at which the whole product range has to be specified, because a clause that cannot be measured cannot be enforced, and the audit then has something to audit against rather than an impression to recall.

3. Life Safety, Fire Codes & Environmental Compliance

Certification claims are the area where an audit most often produces false comfort, because a certificate can be genuine, current, and still not apply to the buyer's order.

Reading a fire certificate correctly. Foliage is typically IFR to NFPA 701 as standard on commercial builds, and EN 13501-1 Class B-s1,d0 is available for EU-tendered projects. The audit should establish three things beyond the document's existence: the test method used (NFPA 701 Method 1 and Method 2 are not interchangeable), whether the report covers the construction actually ordered — method, build-up and face weight all matter — and whether the certificate names the producing entity, not a trading company that resells it. A certificate in the name of a different legal entity is the most common form of this problem and the easiest to spot on site.

Quality-system documents. An ISO 9001 certificate tells the buyer that a documented quality system exists; it does not tell the buyer which factory the certificate covers, or whether the scope includes the product line being ordered. The audit should confirm the scope statement and the site address on the certificate, and cross-check against the site visited.

Warranty and spares as compliance items. A warranty that names no duration, no excluded conditions, and no spares availability is decoration. The defensible version states the period in writing, defines what voids it, and commits to a spares proportion — for foliage-heavy large trees, 3–5 percent spare foliage or crown modules is the figure that keeps a hotel atrium maintainable after damage.

Environmental compliance. Low-VOC, odour-free cured polymer is the correct baseline for closed HVAC environments. For EU-tendered work, REACH compliance should be evidenced by the supplying entity, again under its own name.

4. Technical Comparison Table

The table below converts the audit checklist into payment milestones. The right-hand columns are the part that matters commercially: each release is attached to a verifiable event, and the retention stays in the buyer's hands until the goods are in the destination port.

Order Value BandDepositRelease 2 (Against Sample)Release 3 (Against Pre-Shipment)RetentionGoverning Document at Each Stage
Under USD 15,00030% on PI—70% on B/L copy0%Signed first-article sample + packing list
USD 15,000–60,00030% on PI—60% on pre-shipment inspection pass10% on arrivalSample + AQL inspection report + mill certs
Above USD 60,00020% on PI30% on approved sample + shop drawings40% on pre-shipment inspection pass10% on arrivalFull dossier: sample, drawings, certs, traceability labels

How to read this table. The bands are indicative ranges used for structuring a first order, not published figures — the point is the shape of the ladder, not the exact percentages. Two structural features matter more than the values: the deposit is never released without a signed sample, and the retention is always held against the physical goods. A supplier who insists on 100 percent against a B/L copy is asking the buyer to surrender every remedy at the moment the goods leave the factory gate.

What each milestone actually verifies.

  • Signed first-article sample. Fixes colour, frond density and trunk finish before mass production. Must be dated, signed by both parties, and retained by both. Cut a small section and keep it — a full tree cannot be couriered back to a dispute.
  • Pre-shipment inspection. A defined AQL sampling applied to the packed goods, not a visual walk-through. It is the last moment when a defect can be corrected cheaply, because it is before the container is sealed.
  • Mill certificates for the core. Evidence that the tube is what the specification says, independent of the finished appearance.

5. Structural Anchoring & MEP Coordination

The commercial clauses and the technical requirements meet at handover, and this is where the audit's output becomes a document set rather than an impression. Four items should be produced as deliverables, and each should be named in the purchase order so that its absence is a contractual event rather than an argument.

1. The anchor and base detail for the project's own substrate. Either a calculation signed by a qualified engineer, or a specification with the fastener grade, galvanizing class and embedment — the project's engineering calculations should be issued as a deliverable, not implied by a generic note. 2. Shop drawings with a revision number and a freeze date. Drawings that keep changing after production starts are the mechanism by which an approved design becomes something else; the freeze date is what makes the version signed off the version built. 3. Packing list with part numbers per piece. Multi-piece trees are the case that exposes this — a tree shipped in four pieces needs the crown labelled to the trunk, or the site crew cannot match them. 4. A handover file containing the sample reference, the inspection report, the certificates under the producing entity's name, and the traceability labels. This is the file that is read five years later when something fails.

MEP coordination as a contractual interface. Sprinkler throw clearance, air-curtain lateral load at a rooftop entrance, and the waterproofing detail at a drilled anchor are all interfaces between the tree supply and other trades. The audit cannot verify a design that has not been issued, so the practical rule is that the anchor and MEP coordination drawings should be a condition of Release 2, not an item to be sorted out after the container ships.

An autumn maple tree standing in the factory yard outside the workshop door A finished tree standing in the factory yard outside the workshop door, with packing crates and materials around it — the premises a site visit should confirm independently of any document.

6. Commercial Contractor FAQs

Q: Is a factory visit enough to protect a first order?

A: No, and treating it as sufficient is the most common mistake. A visit confirms that the premises, the people and the production equipment exist on the day of the visit. It does not bind the supplier to repeat that standard on the next production run. The visit is worth doing — it is how a buyer separates a real workshop from a trading office — but its output should be a signed sample and a set of named deliverables, not a set of photographs.

Q: What deposit structure is reasonable for a first artificial tree order?

A: A ladder with the deposit tied to a signed first-article sample, one or two intermediate releases tied to verifiable events, and a retention held until the goods arrive. For an order in the middle bands, a 30 percent deposit with a pre-shipment inspection gate and a 10 percent retention is a workable starting point. The structural principle is that no release should be attached to a document the supplier produces alone.

Q: How do I tell a factory from a trading company?

A: Three checks, and none of them is the showroom. First, the legal entity on the fire and quality certificates should match the entity you are contracting with — a certificate in a third party's name is the clearest signal. Second, the quotation, the proforma invoice and the receiving bank account should resolve to the same company; a changing payee is the most reliable warning sign. Third, ask to see a sectioned joint and the tube stock, and to measure the wall thickness — a trader can arrange a showroom but usually cannot produce a shop-floor answer to a technical question on the spot.

Q: What should the retention be held against?

A: The physical goods arriving in the condition that was inspected. The retention is released after arrival and inspection, against the handover file rather than against any single document. Where a project has a defect-liability period — hotel groups and developers commonly impose one — the retention clause should reference it explicitly rather than assume the warranty covers the same ground.

Conclusion: Put the Clauses Around the Sample, Not Around the Photographs

A factory audit is worth the trip, but it is a photograph of a moment. What survives the order is the paperwork around it: a signed first-article sample that both parties retain, a payment ladder in which every release is attached to an event the buyer can verify, mill certificates for the core, and a handover file assembled as a deliverable rather than as a favour.

The sequence that works is short. Visit, then sign the sample and cut a retention section from it. Write the release conditions into the purchase order before the deposit is paid. Name the four handover deliverables — anchor detail, frozen shop drawings, part-numbered packing list, and the certificate set under the producing entity's name. Hold the last 10 percent until arrival.

If a first order is being structured now and the payment terms are still open, our engineering team can supply the sample protocol, the specification values that make each milestone checkable, and the submittal package the handover file should contain.
