Executive Summary

A large artificial tree project takes 18–24 weeks from drawing freeze to handover, and only 25–35 days of that is production. The rest is drawing approval (3–5 weeks), finish sample sign-off (2–4 weeks), pre-shipment packing and inspection (3–5 days), ocean transit (18–30 days on Gulf lanes), destination clearance and delivery (5–10 days), then 3–6 days per installation zone. Production is rarely the critical path. The milestone that slips is usually the written approval of the finish sample.

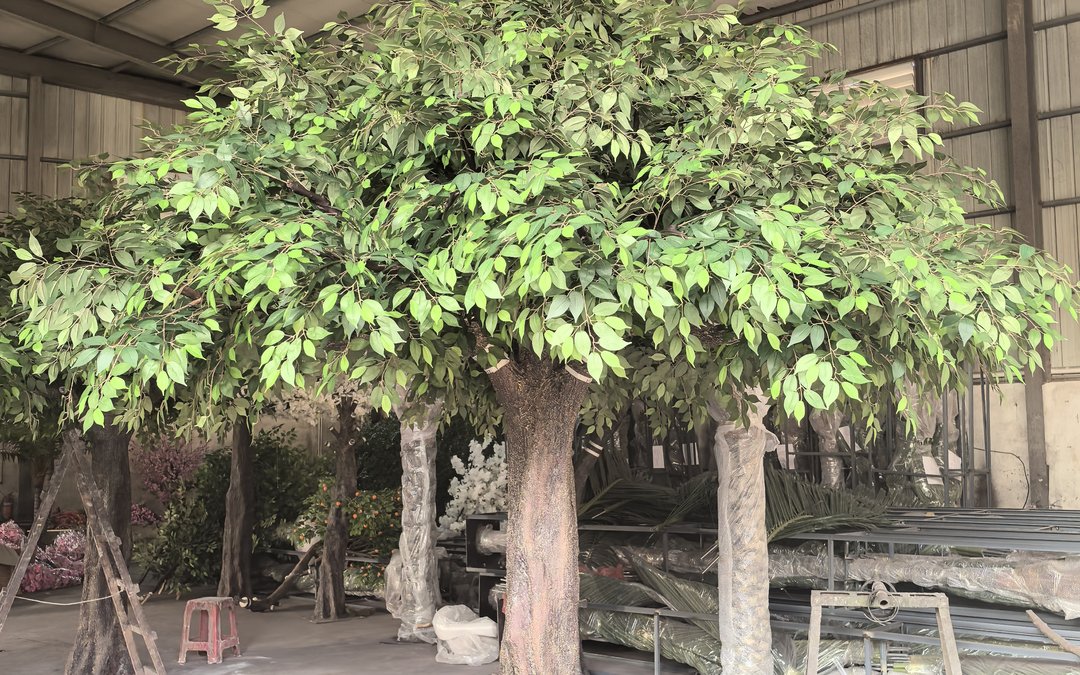

Large artificial ficus trees at different production stages inside the workshop Inside the production bay: a finished ficus crown beside trunks still under protective wrap — the work-in-progress stage that the production window covers.

1. What Goes Wrong Without This

Lead time failures on tree packages are rarely caused by a slow factory. They are caused by a programme that was built forwards from the purchase order instead of backwards from the opening date, and by milestones that were never given an owner.

The finish sample becomes the critical path, unnoticed. Production can start the day drawings freeze. It cannot start the day a colour is almost agreed. A silvery olive foliage sample that is signed off in writing on day 20 rather than day 5 pushes everything downstream by two weeks, and nobody notices until the delivery date moves — at which point the finish discussion has already cost more than the sign-off would have. Colour and trunk finish approvals are the least technical and the least planned item on the programme.

Drawings freeze late, and then change. A shop drawing set that is issued as a concept and then revised twice after the deposit restarts the production clock each time, because the factory cannot build against a moving dimension. Ceiling void height, fixing method and MEP clearance all have to be resolved before freeze; leaving any of the three open is a decision to extend the programme by an amount nobody has written down. Building the drawing freeze into the contract as a dated milestone rather than an intention is what stops this.

The shipping leg is planned as a constant. Ocean transit into Gulf and Red Sea ports has not behaved as a constant through 2026: routings have changed, sailing windows have moved, and equipment availability for oversized units has been uneven. A programme that allocates 22 days for transit and no contingency is not a plan, it is an assumption. Booking windows and rate validity on these lanes are short enough that the sailing date should be confirmed close to the goods being ready.

Site readiness is assumed rather than scheduled. Trees arriving on a floor where the stone is still being laid will sit in their cradles for a fortnight, and their packing will be opened and re-closed to check for damage. That is a real cost, and it doubles if the storage area is a finished lobby. The access window, the offloading equipment and the floor-finished date all belong on the same page as the vessel schedule.

Nobody owns the customs and approval file. The material documents, the fire test report naming the shipped construction, the packing list with piece numbers and — on some routes — the platform-level conformity record are all produced at the factory but often not transmitted until they are asked for. A document that is complete at the factory but unread at the port is functionally missing.

The cost of all five is the same in structure: the installation crew, the crane and the access window are booked against a date, and a date that moves takes all three with it. On a hotel or mall opening, that cost is usually larger than the freight.

2. The Decision Framework

The framework below is written so a procurement lead can work through it without a planner. Each item has a decision attached to it, not just a question.

1. Fix the handover date first, then work backwards. Every other date in the programme is derived from the date the space must be usable. Working backwards from the order date produces an optimistic number; working backwards from the opening date produces a plan.

2. Identify the real critical path. For most tree packages it is not production. Rank the four candidate paths — drawing approval, finish sample sign-off, production, transit — and manage the longest one. If two are within a week of each other, treat them both as critical and give each a named owner.

3. Freeze the drawings before releasing the deposit. A freeze means the dimensions, the fixing method and the ceiling void clearance are fixed and signed, not that a drawing has been issued for comment. Changes after freeze are legitimate; they should be costed and dated rather than absorbed.

4. Approve the finish as a physical object, in writing. Keep a signed sample of the foliage colour and the trunk finish, reference it in the purchase order, and date the approval. This single artefact resolves the majority of late-stage disputes, because it converts a conversation into a standard.

5. Settle the shipping mode at quotation, not at packing. The mode follows from the longest knocked-down piece, and that is a drawing-stage decision. Deciding it late means rebuilding the breakdown to suit a container that has already been booked.

6. Book the site access window before the vessel sails. Night works, mall trading hours and hotel soft-opening schedules all constrain when a tree can be moved in. An access window booked after arrival is a storage cost with a date attached.

7. Assemble the documents 8–12 weeks out. The fire test report, material declaration, shop drawing set and packing list should be collected at the factory and transmitted before loading. Approval cycles at destination commonly run in the range of one to four weeks, and an incomplete submission restarts that clock.

8. Give every milestone one owner and one date. A milestone with two owners has none. Write the date into the purchase order and treat it like a contractual date, because on the receiving side it is one.

9. Quantify the weekly cost of delay before you need it. Crane hire, installation crew, site storage and the opening date all have a weekly number. Having it agreed in advance turns a programme discussion into an arithmetic one.

10. Order spares with the first shipment. Foliage modules and fixings at 3–5% of the order quantity cost a fraction of a later air-freight consignment, and they arrive on the same vessel rather than in a crisis.

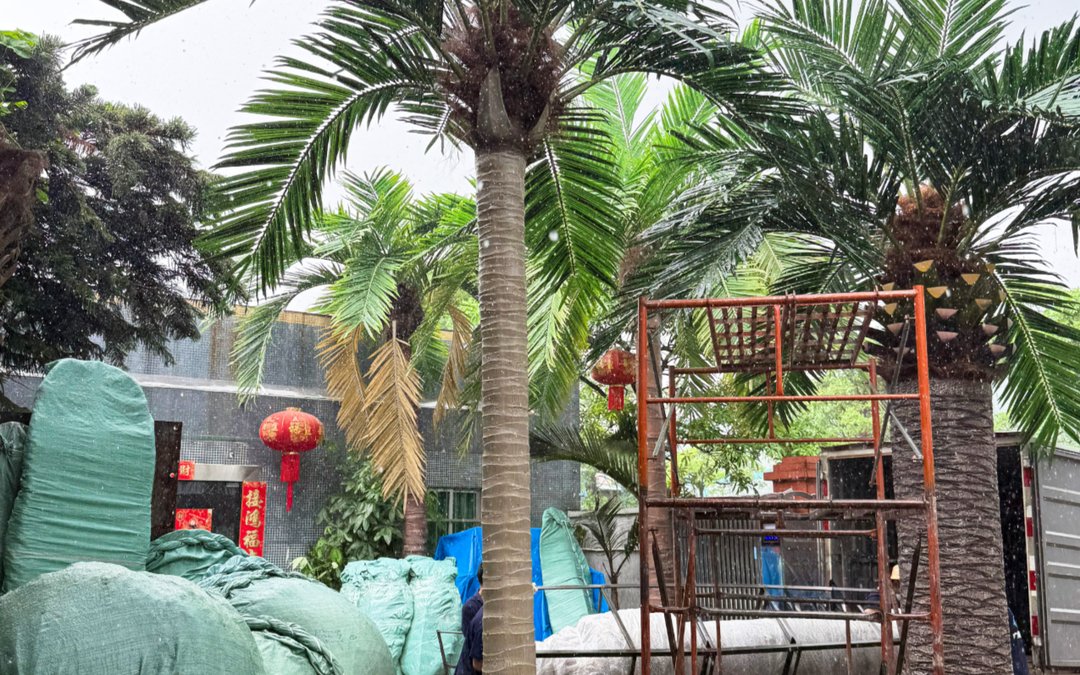

Artificial palms staged in the factory yard in the rain beside tarped export bundles Yard staging in the rain: palms waiting beside tarped export bundles and a loading tower — the window where shipping documents must all be complete before the container is sealed.

3. Numbers, Tiers and Timelines

Durations below are working planning figures for commercial tree packages, not commitments. They are stated so a programme can be built and challenged; the tiers are the more useful half of the table.

PhaseTypical DurationWhat Gates ItWho Owns It
Concept, species selection and quantity take-off1–3 weeksSite dimensions, floor loading, ceiling void heightBuyer with designer
Shop drawings and approval to build3–5 weeksFixing method, MEP clearance, written sign-offBuyer's consultant
Finish sample and first-article approval2–4 weeksSigned foliage colour and trunk finish standardBuyer
Production25–35 days standard heights; 45–60 days for custom builds above 6 mDeposit received and drawings frozenSupplier
Pre-shipment inspection and export packing3–5 daysPacking list with piece numbers; inspection slotSupplier and buyer's inspector
Ocean transit18–30 days to Gulf ports; longer when routings changeBooking, equipment availability, cut-offForwarder
Destination clearance and inland delivery5–10 daysDocument set completeness; abnormal-load permitImporter
Site installation and handover, per zone3–6 daysAccess window, floor finish, MEP readyInstallation contractor

Three project tiers follow from those phase durations, and the tier is what a buyer should quote internally rather than a single lead-time figure:

TierScopeRealistic Door-to-Handover WindowWhere the Buffer Belongs
AOne or two feature trees, standard heights, no custom drawing10–14 weeksAfter the finish sample approval
BMulti-tree atrium or lobby package with shop drawings and sample approval18–24 weeksAfter drawing freeze and after sailing
CFull commercial roll-out, several species, phased site access, approval file26–34 weeksAfter production and again before the opening date

Read the two tables together and one conclusion stands out: a Tier B package spends roughly twice as long outside production as inside it. That ratio is why trimming 5 days off the factory window buys almost nothing, while approving the finish sample 10 days earlier buys the whole programme.

The percentages worth holding in mind. Roughly 15–20% of a Tier B window is drawing and approval work on the buyer's side, around 20–25% is production, 20–30% is transit and clearance, and the remainder is installation and float. If a programme shows production consuming more than a third of the total window, the approval phases have probably been under-planned rather than the factory being slow.

4. How to Apply It to a Live Project

The framework only earns its keep if each decision lands in the right phase. The sequence below maps it onto a live project from enquiry to handover.

Enquiry and quotation. Settle the shipping mode here, because it follows from the breakdown. Provide the site location, access constraints and the installation environment — an interior hotel atrium and an exposed forecourt need different builds, and the difference affects both the drawing and the lead time. Ask for the piece-level packing sheet with the quotation so the freight enquiry is built on real dimensions rather than on tree height.

Sample and specification approval. This is the phase to spend attention on, not to rush through. Approve the foliage colour and trunk finish against a physical sample, in writing, with a date. Confirm the fire documentation standard at the same time, because it is produced from the same build and travels with the same consignment.

Drawing freeze. Fix the ceiling void clearance, the fixing method and the load path. Where the fixing needs site-specific engineering calculations, they should be completed before freeze rather than alongside production. A drawing that is 95% final is not frozen.

Production. The window starts on the later of two dates: deposit received, and drawings frozen. Both are the buyer's to control, which is why they matter more than any factory-side acceleration. First-article inspection at the mid-point of production is worth more than a final inspection, because it catches a colour or density deviation while there is still time to correct it.

Pre-shipment and loading. Confirm the packing list against the piece numbering on the goods, complete the document set, and close the verified gross mass declaration before the cut-off. This is also the last point at which a spare-parts quantity can be added without a separate consignment.

Shipping and clearance. Confirm the sailing, the routing and the rate close to booking, and keep the destination document pack moving in parallel with the vessel rather than after it. Where the delivery leg needs an abnormal-load permit, that application runs in this window.

Delivery, installation and handover. Match the installation window to the floor-finished date, not to the arrival date. Sequence the zones so that access is available where it is needed, complete the verticality and fixing checks zone by zone, and clear the cradle timber before the finishing trades move in.

Rows of artificial palms around a glass-domed indoor pool The end of the programme: rows of artificial palms installed around a glass-domed pool, where every earlier milestone — drawing freeze, sample approval, sailing, access window — has already been paid for.

5. Commercial Contractor FAQs

Q: How long does a large artificial tree project actually take?

A: A multi-tree atrium package normally runs 18–24 weeks from drawing freeze to handover, of which production is 25–35 days for standard heights and 45–60 days for custom builds above 6 m. A single feature tree with no custom drawing can complete in 10–14 weeks. A full commercial roll-out with several species and phased site access runs 26–34 weeks. The variable between these tiers is approval and logistics, not manufacturing.

Q: What is usually the critical path on a tree package?

A: The written approval of the finish sample, and second to it the shop drawing sign-off. Production can only start against a frozen drawing and an agreed colour, so any delay in those two milestones moves the whole programme one-for-one. Production itself is comparatively fixed. A programme that manages the factory closely and the approvals loosely has its effort in the wrong place.

Q: Can production be accelerated if the opening date moves in?

A: Partly. The production window can be compressed on standard builds, and the factory route can often be resequenced. What cannot be compressed is the approval sequence at destination or the ocean transit. If a programme is short by two weeks, the realistic options are to air-freight a partial consignment, to phase the installation so the feature trees land first, or to accept a later opening for one zone. Attempting to compress transit or approval is how dates get missed.

Q: How much buffer should be built into the programme?

A: Plan for buffer at two points rather than spreading it evenly: after the finish sample approval, and again between sailing and the site access window. Four to six weeks of total float on a Tier B package is a reasonable planning assumption, and it should be held by the buyer rather than absorbed by the supplier, because the buyer controls the two milestones most likely to consume it.

Q: Who should own the customs and approval documentation?

A: The importer owns it at destination, but the evidence is produced at the factory, so the work is shared and the handover point has to be explicit. The practical arrangement is that the supplier transmits the complete document set before loading, and the importer confirms receipt and suitability against the destination requirement at least eight weeks before the goods arrive. A document set assembled at the port is a document set assembled too late.

Q: Does ordering spares change the lead time?

A: It should not, if they are ordered with the first shipment rather than after it. Foliage modules and fixing hardware at 3–5% of the order quantity travel in the same container and add volume rather than time. Ordered later, the same parts become a separate consignment with its own transit window, which is typically 4–8 weeks on the same lane — and it usually happens at the moment a replacement is urgent.

Conclusion: Set the Handover Date First and Make the Approvals Keep It

Lead time on a large tree package is decided by the milestones the buyer controls — the drawing freeze and the finish sample approval — long before it is decided by anything the factory does. Build the programme backwards from the handover date, give each milestone one owner and one date, hold the buffer where the risk actually sits, and 18–24 weeks stops being a guess. Our engineering team issues the shop drawing set, the piece-level packing list and the loading plan against a frozen revision, and holds a signed finish standard on file, so the programme, the production window and the freight booking all reference the same dates. Send the handover date, the site access constraints and the species list, and we will return a dated schedule with the approval milestones marked and the float shown where it is genuinely available. The species covered are listed in the product catalogue, and delivered projects show how the phasing works on a live commercial atrium installation.
